bKAGRA Phase2
- Target: Joining O3 with ~10Mpc of BNC.
- Term: 2018/5/7 ~ 2019/May?

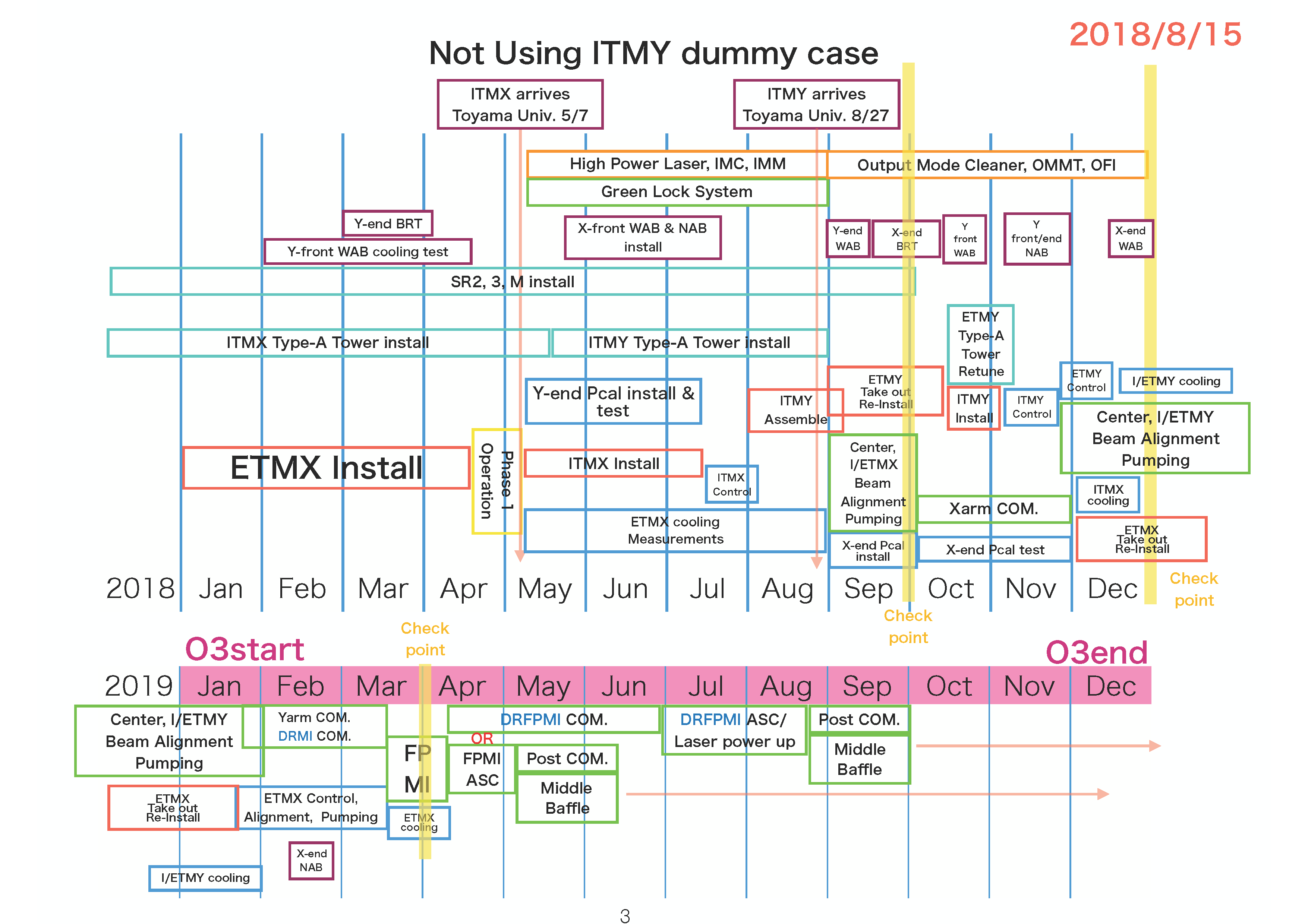

Schedule
2017/8/21 updated
HPL stage
- Target: High power laser
- Term: 2018/5/7 ~ 2018/8/31
XA stage
- Target: X arm commissioning
- Term: 2018/9/1 ~ 2018/12?
- Milestone
- VIS ITMX
Check list for ITMX closing
- Initial alignment of X arm
- Cavity lock with IR
- Cavity lock with green
- VIS ITMX
YA stage
- Target: Y arm commissioning
- Term: 2019/1? ~ 2019/3?
- Milestone
- Replacing ETMY
- VIS and CRY of ITMY
- Initial alignment of Y arm
- Cavity lock with IR
- Cavity lock with green
FPMI stage
- Target: FPMI commissioning
- Term: 2019/3? ~ 2019/4?
RSE stage
- Target: DRFPMI commissioning
Observation
- Joinning O3 of LIGO/VIRGO
